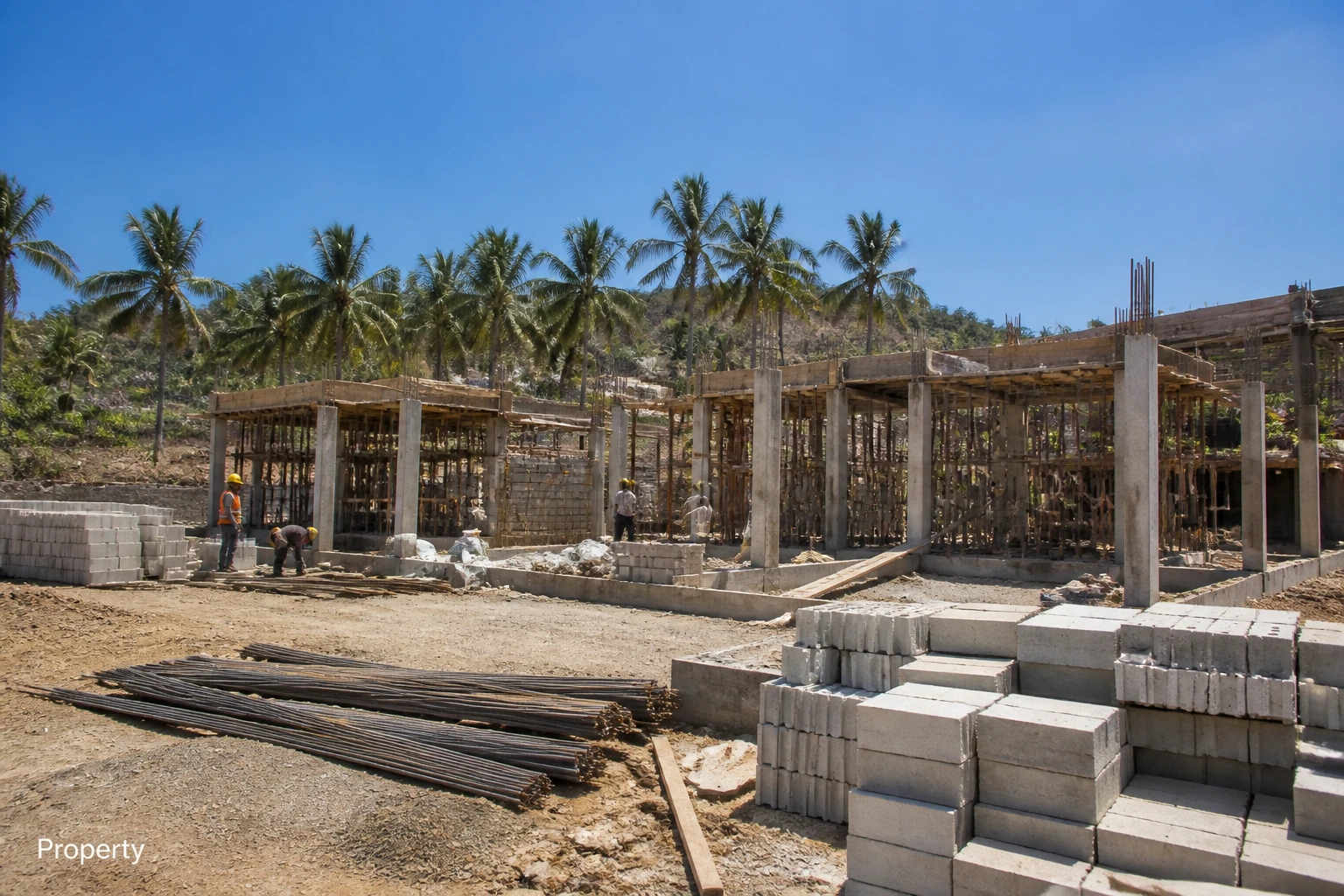

How Much Does It Cost to Build a Villa in Lombok in 2026?
Building a villa in South Lombok in 2026 typically costs between USD 400 and USD 850 per square metre for structure and fit-out, depending on finish level. A 200 sqm three-bedroom villa with good-quality finishes runs USD 80,000 to 170,000 in construction costs alone, before land, permits, and profe
Quick answer: Building a villa in South Lombok in 2026 typically costs between USD 400 and USD 850 per square metre for structure and fit-out, depending on finish level. A 200 sqm three-bedroom villa with good-quality finishes runs USD 80,000 to 170,000 in construction costs alone, before land, permits, and professional fees.
What Does Construction Actually Cost Per Square Metre?
Construction costs in South Lombok fall into three broad tiers, and the difference between them comes down almost entirely to finish quality, not the structure itself.
- Economy finish (locally sourced tiles, basic joinery, no pool): USD 280 to 400 per sqm.
- Standard finish (imported ceramics, hardwood accents, private pool): USD 400 to 650 per sqm.
- Premium or export-grade finish (natural stone, architect-designed interiors, bespoke furniture package): USD 700 to 950 per sqm.
For a purpose-built investment villa of 180 to 220 sqm, most buyers targeting the short-stay rental market settle in the USD 400 to 650 band. At those rates, a 200 sqm villa costs roughly USD 80,000 to 130,000 to build before anything else is added.
Land is a separate line item that varies sharply by zone. In Are Guling, one of the more accessible early-cycle frontiers in South Lombok, land currently runs around Rp 120 to 180 million per are, which is approximately USD 7,300 to 10,900 per 100 sqm. Kuta, the demand and liquidity leader, runs Rp 300 to 400 million per are (roughly USD 18,200 to 24,200 per 100 sqm). Your land budget can equal or exceed your build budget depending on which zone you target. The complete guide to building a villa in Lombok covers plot selection, zoning and the permit sequence in full detail.
Contractor Versus Project Manager: Choosing the Right Model
Foreign buyers face a structural decision early in the process: hire a local contractor directly, or appoint an independent project manager (PM) to sit above the contractor and represent your interests on site.
Direct contractor model. A local contractor typically works on a fixed price or cost-plus basis. Rates can look competitive on paper. The risk is that contract quality and supervision standards vary considerably across Lombok, and a buyer based overseas has limited visibility over what is actually happening on site from week to week.
Project manager model. A licensed architect or experienced independent PM charges roughly 10 to 15 per cent of total construction cost. In return, you receive independent quantity surveying, phased progress inspections, payment releases tied to verified milestones, and an advocate who is accountable to you rather than to the contractor. For a USD 100,000 build, that fee runs USD 10,000 to 15,000. Most experienced buyers regard it as modest insurance against a much larger potential loss.
The practical guidance is straightforward: if you cannot visit the site at least once a month, a PM is not an optional extra. Unsupervised projects routinely encounter material substitutions, schedule drift during the peak dry-season construction window, and scope creep that surfaces only at final handover.
Finishes and Fit-Out: Where Budgets Diverge
The largest cost variable in a Lombok villa build is not the structure but the fit-out. Concrete, blockwork, roofing and drainage are broadly similar across contractors. The gap opens in four areas:
- Tiles and stone. Locally quarried Lombok limestone and Javanese andesite can look excellent at a fraction of the cost of European imports. Italian or Spanish porcelain adds 40 to 70 per cent to floor and wall budgets.
- Joinery and furniture. A bespoke teak furniture package for a three-bedroom villa from a reputable Lombok workshop runs roughly USD 12,000 to 25,000. Ready-made options from Java can halve that figure, with trade-offs in durability and finish quality.
- Pool and outdoor living. A modest overflow or lap pool of four by eight metres adds USD 8,000 to 20,000 depending on coping and tile choice. Outdoor kitchens, landscaping and hardscape routinely add a further USD 5,000 to 15,000.
- Mechanical, electrical and plumbing (MEP). A solar array, increasingly standard in rental villas targeting European guests, adds USD 4,000 to 10,000 but meaningfully reduces operating costs over the lease term.
For a full picture of what a villa costs to own beyond the build, including management fees of 18 to 22 per cent of gross rental revenue, maintenance reserves and annual taxes, the cost of owning a Lombok villa guide is the most practical starting point.
Timelines and Common Budget Overruns
A well-managed villa build in South Lombok takes 12 to 18 months from permit approval to handover. That assumes the building permit (now called PBG under Indonesia's 2021 OSS reform) is handled before any groundwork begins, which typically means a lead time of 2 to 4 months for drawings, site plans and local authority sign-off. Do not allow a contractor to pour concrete before the permit is issued.
Four categories account for the majority of overruns:
- Permit delays. Approval from the local investment and permit office (DPMPTSP) depends on complete documentation. Budget 3 to 5 months and include this in your project timeline from day one.
- Material price volatility. Cement and steel in Lombok reflect shipping logistics from Java and global commodity cycles. A contingency of 10 to 15 per cent on materials is prudent.
- Dry-season labour bottlenecks. Skilled subcontractors in Kuta and Are Guling are absorbed quickly between April and September. Starting groundwork in October or November tends to secure better availability and more competitive rates.
- Mid-build scope changes. Relocating a pool, adding a bedroom or upgrading finishes after structural work has begun is disproportionately expensive. Lock the design before breaking ground and change nothing significant afterwards.
Self-managed builds without site supervision typically overrun by 15 to 25 per cent. Projects with an active PM and a frozen design tend to come in under 10 per cent above the original budget.
Putting It All Together: A Realistic Build Budget
For a 200 sqm three-bedroom investment villa with a pool, standard-to-good finishes and PM oversight, a realistic all-in construction and fit-out budget before land looks like this:
| Item | Range | |---|---| | Structure and finishes | USD 90,000 to 120,000 | | Pool and outdoor areas | USD 15,000 to 25,000 | | MEP and solar | USD 8,000 to 15,000 | | Project manager fee | USD 12,000 to 18,000 | | Permits, notary and BPHTB | USD 5,000 to 10,000 | | Contingency (15%) | USD 20,000 to 28,000 | | Total (excl. land) | USD 150,000 to 216,000 |
Add land in Are Guling at current prices and a fully developed asset can come in at or around USD 255,000, which is consistent with what developers, including Samudra Villas, which is active in Are Guling, are delivering as turnkey off-plan product at that price point. The key distinction is risk: buying off-plan from an established developer transfers construction risk to the developer; self-building retains design control but requires active management throughout.
Before committing to either route, run your rental income assumptions through the ROI calculator to stress-test the numbers at realistic occupancy rates of 55 to 70 per cent and honest net yields of 7 to 12 per cent.
Frequently asked questions
How long does it take to build a villa in Lombok from start to finish?
A well-managed villa build in South Lombok typically takes 12 to 18 months from permit approval to handover. Factor in an additional 3 to 5 months before construction starts for the PBG building permit process, making the total timeline from design freeze to occupancy roughly 15 to 23 months.
Should I hire a contractor or a project manager for my Lombok villa build?
If you cannot visit the site at least once a month, an independent project manager is strongly advisable. A PM charges roughly 10 to 15 per cent of construction cost but provides independent inspections, milestone-based payment releases and material quality oversight. Self-managed builds without on-site supervision routinely overrun by 15 to 25 per cent.
What are the most common reasons villa builds in Lombok go over budget?
The four most common causes are permit delays that compress the build timeline and force premium labour rates, mid-build scope changes to finishes or layout, dry-season subcontractor shortages in popular zones such as Kuta and Are Guling, and material price spikes on cement and steel imported from Java. A locked design, a PM and a 15 per cent contingency reserve address most of these risks.
